Hydro project on Yamuna 'bitter lesson' for those calling it cheap green energy source

By Bhim Singh Rawat*

The 120 Mw Vyasi HEP built by Uttarakhand Jal Vidyut Nigam Ltd (UJVN Ltd.) in Vikas Nagar tehsil of Dehradun is on its way to become the textbook example of how thoughtlessly pushed hydro power projects are proving a nightmare for local people, a costly affair for the state and the nation and a disaster for free-flowing living river.
The project offers some bitter lessons for the policy-makers, experts and society who have been assuming that hydro power is a cheap, green source of energy and the Run of River (RoR) projects don’t dam and cause much harm to the environment, people or rivers.

Past violations unpunished

Like the case with most of hydro projects in the Himalayan region; the Vyasi HEP too has missed several deadlines and suffered cost escalation from Rs. 936.23 crores in February 2010 to Rs. 1777.30 crores upto September 2021.
While in the making for over a decade, the contractor companies brazenly violated several environmental norms including those meant for safe disposal of tunnel debris and construction muck. The project also caused large scale illegal mining in the Yamuna to secure construction materials from the same Yamuna river.
However, in absence of credible monitoring or compliance mechanism, UJVNL have never been held accountable for the irregularities and destruction. There is no information regarding compensatory afforestation against diversion of about 100 hectares of forest land for the project.

Impact on river, people during filling up

The project was prematurely inaugurated in December 2021 but actually came into operation in April 2022 without addressing the Rehabilitation & Resettlement (R&R) rights of agitating Lohari villagers. About 72 homes of the tribal village and several acres of fertile lands have been drowned into the Vyasi dam. Continuing their struggle, many of the displaced families have still been taking temporary shelter in a nearby school.
Meanwhile, with the project commissioned, the unrealistic claims made by UJVNL have also been exposed while the adverse impacts on river ecology are still unfolding. It all began with mass annihilation of fresh water species including the endangered Mahseer fish in huge numbers both in the impounded as well as flowless Yamuna river downstream the dam.T
he farmers from scores of villages dependent on Katapathar canal suffered lack of irrigation water for about three months as the filling up the giant reservoir decreased water flow into the canal from about average 6 cumecs to 1.5 cumecs only. The situation turned so bad that there were fierce protests forcing UJVNL to attend to farmers’ demand.

Yamuna: Once free flowing, now dammed river

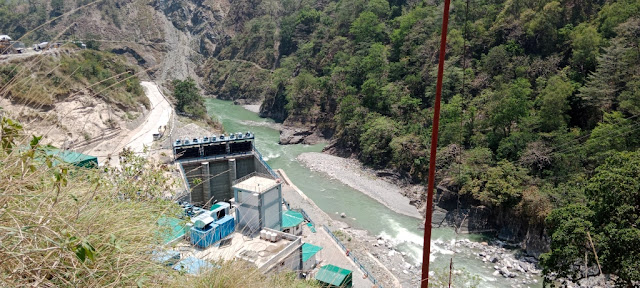

Today, the 86-meter-high gravity dam with a 13.69 million cubic metre gross storage capacity has confined a free flowing and living Yamuna into a about 4 km long reservoir extending along 73 hectares of river banks. With this precious fresh water eco-system including riverine vegetation has been lost into the stagnant water body. Notably, this stretch of Yamuna has been among few unthreatened habitats of Mahseer fish.
There has been no independent assessment on ecological impact of the project before the construction and no plan to address the same even after its being operational. UJVNL has built a fish tank downstream the dam with a plan to rear the fish there and release them in the river. The tank is serving no purpose currently.

Dam filled but the project lacks water to run

Ever since its commissioning, the project has been struggling to generate the power according to its designed capacity of 120 MW as there is lack of required flow in the river. Except for few weeks in monsoon months, the UJVNL has been able to run the project only to a quarter or at most half its installed capacity.
Even during monsoon season, power generation has been compromised by the amount of silt and flood level in the river. The water flow in the river during winter are usually lower than monsoon and summer.
In the peak summer season of June 2023, the Vyasi HEP is kept operational for just about 10 hours from 01:00 pm to 11:00 pm generating about 45 Mw for about 7 initial hours and 120 MW for about last 3 hours. The generated power is being sold to the Power Transmission Corporation of Uttarakhand Ltd. (PTCUL) at Rs 7 per unit. The PTCUL further transmits and distributes the power to the Uttarakhand Power Corporation Limited (UPCL) or national grid according to the demand placed which varies on daily basis.
Clearly, the Vyasi HEP is somehow managing to operate at less than half of its installed capacity even in summer. The main reason behind the gross under performance is outdated, biased assessment reports based on which the project was pushed, these reports grossly underestimated significant decline in overall flows in Yamuna and its tributaries over the years on account of man-made reasons as well as climate change.
Muck from Vyasi HEP tunnel dumped close to the river bank
Given the ongoing and planned tapping of feeding streams and Yamuna itself for growing potable water and irrigation requirements in the catchment, there is likely to be a further decline in flowing water in the river in future. A case in point is Rs. 144 crore Mussoorie water project which is in final stages and would pump out 12 MLD of Yamuna water some 20 km uphill upstream from the Vyasi HEP site.

A farce called e-flows

In the name of environmental flows (e-flows), the UJVNL has been releasing just 5 cumecs of water downstream the river through an inbuilt pipe in dam structure. More than half this e-flow is comprised of the seepages collected inside the dam. The dam gates are opened only for repairing, desiltation purposes or when dam is filled to its capacity.
Project was prematurely inaugurated in Dec 2021 and came into operation in April 2022 without addressing the R&R rights
As a result, about 6 km long stretch of the river between dam at Juddo and power station at Hathyari is deprived of essential flows where the aquatic lives struggle to survive in the almost flowless river. This is despite two perennial streams joining the Yamuna between the dam and power station of the project.
As per local people, the situation was even worse in 2022-23 winter months than the current summer season. They said that the mighty Yamuna was reduced to a trickle between project dam and Dakpathar barrage causing frequent deaths of fish and other aquatic lives. The UJVNL and Central Water Commission (CWC) are required to remedy the situation on urgent basis.

Hungry waters turning river into danger zone

Another serious problem created by the Vyasi HEP is that the project has converted the otherwise safe river banks into a danger zone for local people, tourists and domestic animals. The silt free water known as hungry waters discharged from the power station of the project has been causing sudden fluctuations in the river which is detrimental to the proliferation of the aquatic eco-system.
The project has altered the natural flowing pattern of the Yamuna and greatly increased the eroding capacity of the river which is evident from the fact that the river is dangerously eating into its left bank along the Bausan village, downstream the project.
The average inflows in the river during third week of Jun 2023 have been around 30 cumecs. While the dam has strangulated the river of flows, the power station, when it operates, has been dumping about twice or three time more silt free water than the river would have carried in natural state.
The UJVNL has placed several warning boards, installed sirens at three places and deployed a mobile van plying along the 20 km of the project affected area alerting people to stay away from the river. But these measures appear inadequate to prevent any untoward incident.
The local people have found the deafening noise of the sirens annoying, sometimes blaring out in the dead of night which has been toned down following complaints. The farmers and fishermen have been trying to get accustomed with artificially controlled flows and floods in the river. They have to stay watchful for their wards and cattle whenever the sirens blare out

Vyasi HEP disaster preparedness lagging behind

This is so far the tallest and biggest dam on main stem of Yamuna in a geologically and climatically vulnerable region. The project area has been riddled with new and old recurring landslides. Only in August 2021, there have been cloud bursts induced flash floods both at the power station and dam area impacting the project. Despite this. UJVNL has not installed the Early Warning System (EWS).
Hiding Behind Lakhwar Dam
As the adverse impacts and failures of Vyasi HEP have come in open, the UJVNL and contractors’ lobby have started promoting Lakhwar dam as a panacea for all the shortcomings of the Vyasi HEP. Recently the L&T company is learnt to have secured Rs. 3200 crore tenders for civil construction work of the Lakhwar dam project and has started building shelters for workforce there. The work on the dam is reportedly to begin after the south west monsoon 2023.
The proposed massive 204-m high Lakhwar dam, if built, will further turn more than 40 km stretch of free-flowing Yamuna into a watery grave apart from submerging over 50 villages. Sadly, in the global era of large dam removal and in the face of growing dam induced disasters in Himalayan region, the Indian government is still investing in such multi-billion giant dam project on the basis of four-decade old questionable feasibility and EIA reports to cover up the follies of Vysai HEP instead of learning lessons from it.
---
*Source: South Asia Network on Dams, Rivers and People

Comments

TRENDING

Beyond India-China borders: Economic links expand, political gaps persist

By Bhabani Shankar Nayak*  Despite growing trade between India and China, a persistent trust deficit continues to shape their bilateral relationship. Expanding economic engagement has not fully resolved political differences, many of which stem from historical legacies as well as contemporary geopolitical concerns. Border disputes—often traced to colonial-era arrangements—remain a significant obstacle to deeper cooperation, while differing strategic alignments in global affairs add further complexity.

GreenTech Summit claims NCR as key green building hub, without pan-India comparison

By A Representative   The Indian Green Building Council (IGBC), under the Confederation of Indian Industry, held its GreenTech Summit 2026 in New Delhi, where industry representatives, policymakers and sustainability professionals discussed the adoption of climate technologies in India’s built environment.

Gujarat cadre to HDFC: When bureaucratic style hits corporate walls

By Rajiv Shah   I was a little amused by the abrupt March 17, 2026 resignation of Atanu Chakraborty —a Gujarat cadre IAS officer of the 1985 batch who retired from the government in 2020—as chairman of HDFC Bank . Much of what may have led to his decision to quit this ostensibly high post—actually a non-executive, part-time role—is by now well known. I followed most of it online with considerable interest, partly because I had interacted with him umpteen times during my stint as The Times of India correspondent in Gandhinagar from 1997 to 2012.

Operation Epic Fury: Making America great at the world’s expense?

By N.S. Venkataraman*  ​The decades-long enmity between Iran and Israel is well-documented, but historically, their direct confrontations have been brief, constrained by the logistical and economic limitations of sustained warfare. The current conflict in the Middle East, however, marks a radical and dangerous departure from this pattern.

Swami Vivekananda's views on caste and sexuality were 'painfully' regressive

By Bhaskar Sur* Swami Vivekananda now belongs more to the modern Hindu mythology than reality. It makes a daunting job to discover the real human being who knew unemployment, humiliation of losing a teaching job for 'incompetence', longed in vain for the bliss of a happy conjugal life only to suffer the consequent frustration.

Buddhist shrines were 'massively destroyed' by Brahmanical rulers: Historian DN Jha

Nalanda mahavihara By Rajiv Shah  Prominent historian DN Jha, an expert in India's ancient and medieval past, in his new book , "Against the Grain: Notes on Identity, Intolerance and History", in a sharp critique of "Hindutva ideologues", who look at the ancient period of Indian history as "a golden age marked by social harmony, devoid of any religious violence", has said, "Demolition and desecration of rival religious establishments, and the appropriation of their idols, was not uncommon in India before the advent of Islam".

India has been getting its economic growth wrong for two decades, say top economists

By Jag Jivan*   India's official GDP figures have misrepresented the trajectory of the world's fifth-largest economy for the better part of two decades, according to a major new working paper published by the Peterson Institute for International Economics (PIIE). It finds that India overstated annual growth by up to two percentage points after 2011 — and understated it during the boom years of the 2000s.

Beyond the election manifesto: Why climate is now a kitchen table issue

By Vikas Meshram*  March has long been a month of gentle transition, the period when winter softly retreats and a mild warmth signals nature’s renewal. Yet, in recent years, this dependable rhythm has been disrupted. This year, since the beginning of March, temperatures across vast swathes of the country have shattered previous records, soaring to between 35 and 40 degrees Celsius in some regions. This is not a mere fluctuation in the weather; it is a serious and alarming indicator of climate change .

Jerusalem's Al Aqsa mosque under siege: A test of Muslim solidarity and Palestine’s future

By Syed Ali Mujtaba*  In the cacophony of Israel’s and the United States’ attack on Iran, one piece of news has been buried under the debris of war: Israel has closed the Al Aqsa Mosque in Jerusalem to Palestinian worshippers during the holy month of Ramadan. The closure, announced as indefinite, affects the third most revered mosque in the Islamic world.
